Gantt editor

Andamio

The scaffolding for your plan: a Gantt editor that lives in your browser. ("Andamio" is Spanish for scaffolding.)

  • Active
  • Since 2026
  • Built with
    • React 19
    • TypeScript
    • Vite
    • Tailwind CSS
    • Mermaid

Why we built it

We wanted a plan we could draw in minutes, keep on our own machine and paste into a README, without signing up for a project management service. Andamio does that: it runs in the browser, stores plans in localStorage, and exports to Mermaid, which GitHub and Notion render natively.

It also makes the time that reviews take visible. Most plans hide it inside the effort estimate; here it is a separate part of the calculation, so a task that is two days of work and three days of back-and-forth says so.

Until September 2026 it was called Project Manager. Since October 2026 the app lives at andamio.vedratic.com. The old address, project-manager.vedratic.com, still works and still has your plans: they are kept in the browser for each address, so to move them, export them as JSON at the old address and import them at the new one.

How it works

Three views of the same plan, and one rule for dates.

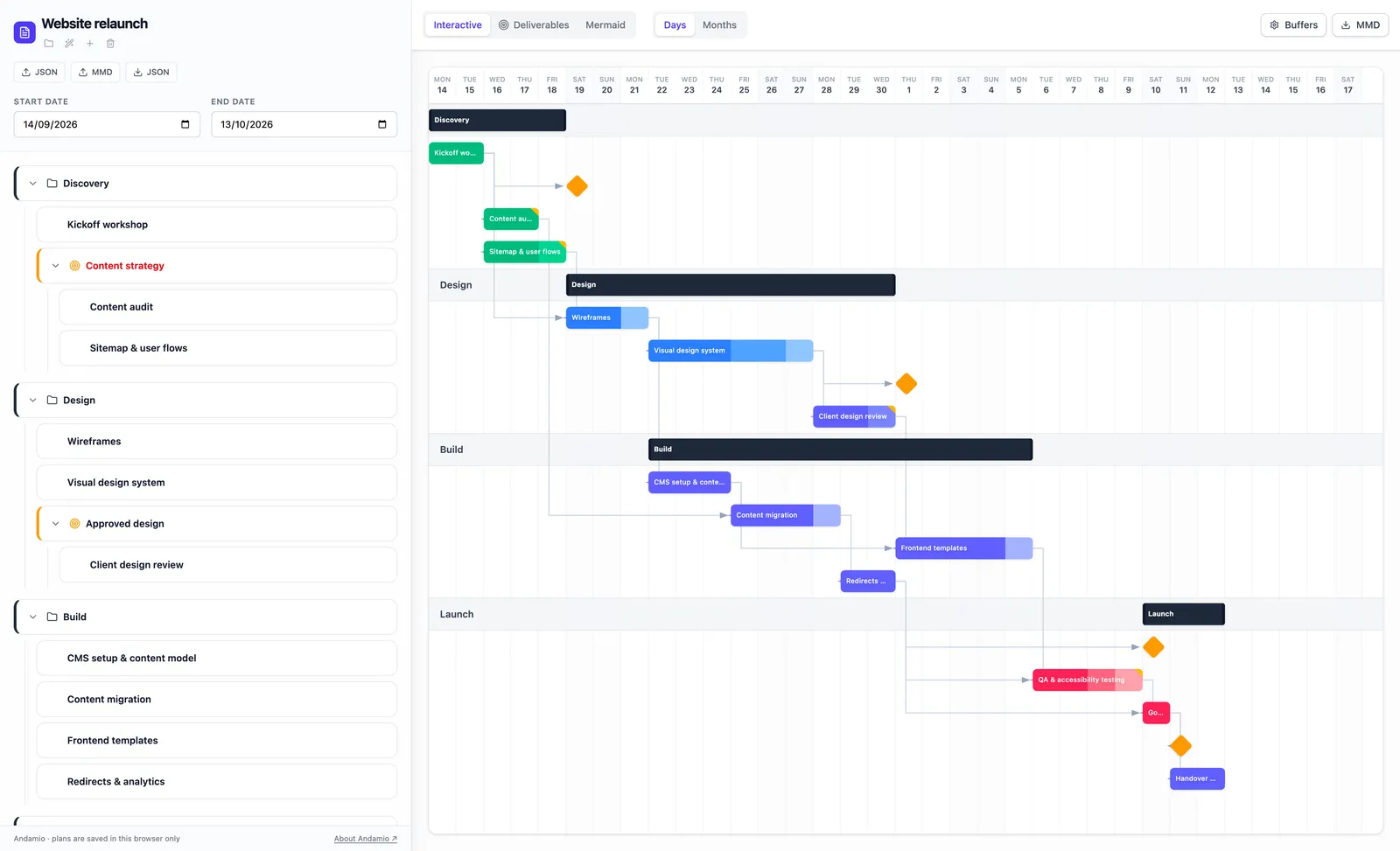

Interactive

The Gantt chart and the task list side by side. Phases contain tasks; each task has a type, effort, timespan, buffer, status and the tasks it depends on, which you link by dragging from one bar to another.

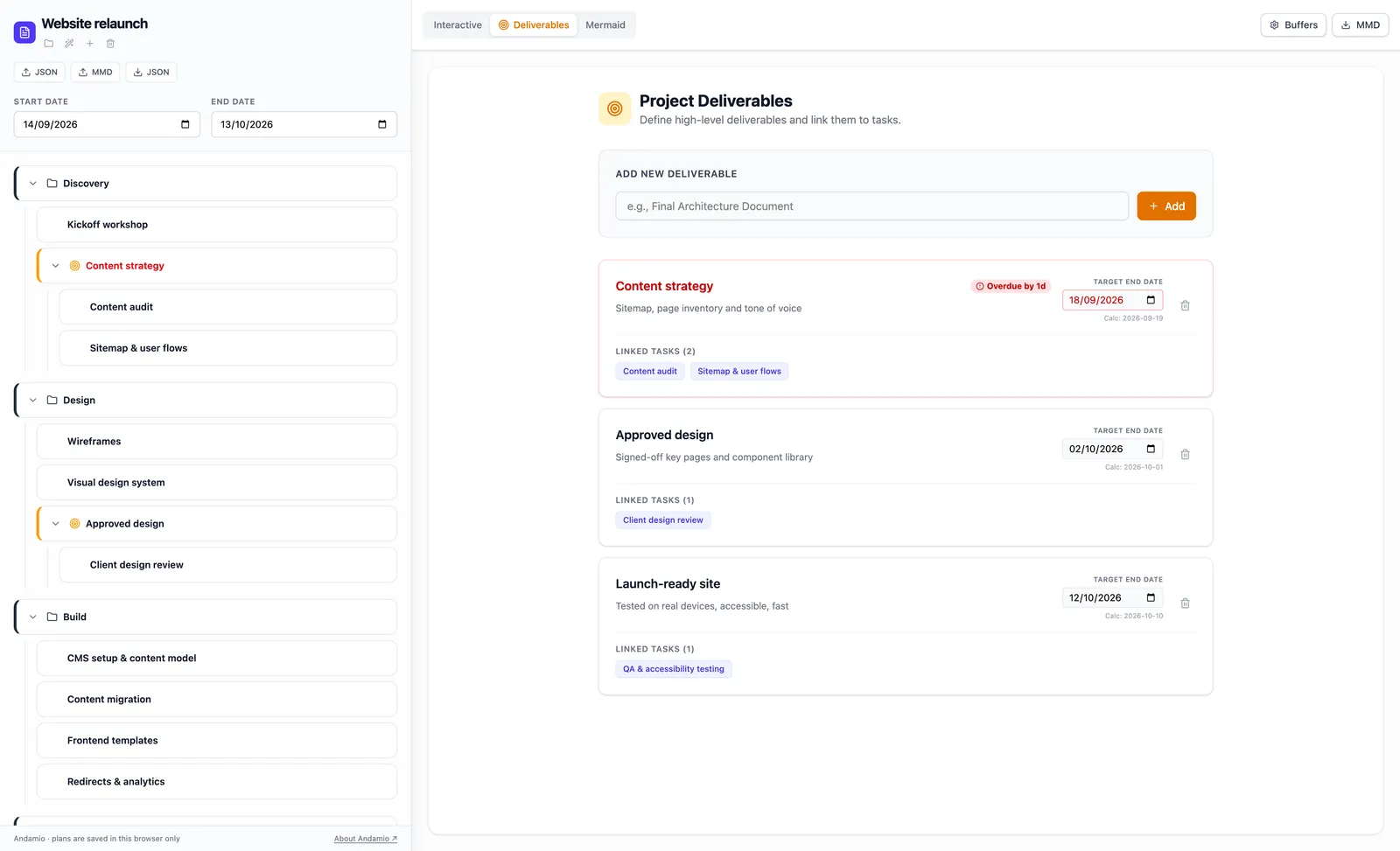

Deliverables

The plan seen by outputs: define what the project has to produce and which tasks lead to each one, for people who care about outcomes rather than task lists.

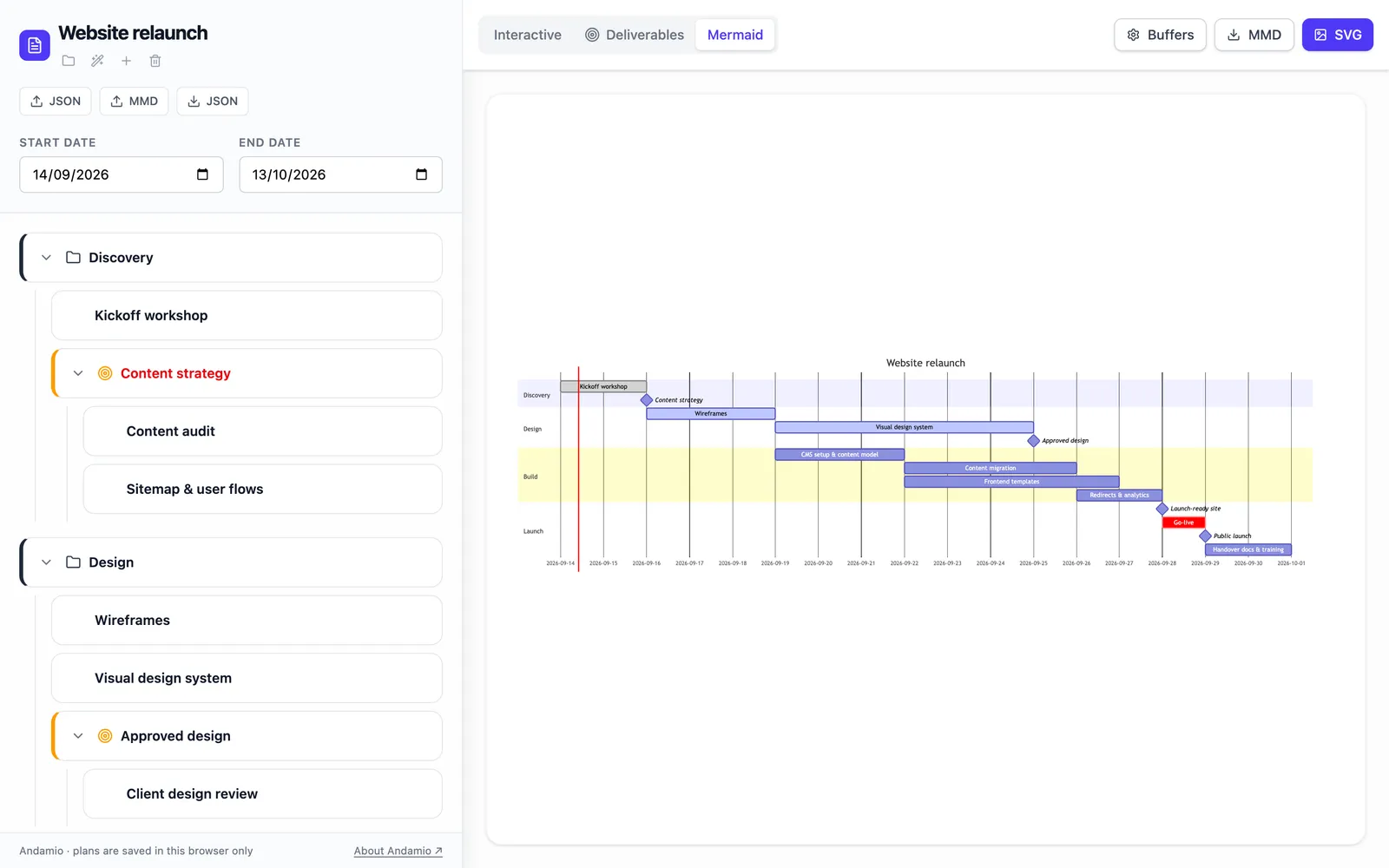

Mermaid

The plan as a Mermaid Gantt chart, with its code. Download it as .mmd to paste into a README, or as .svg for slides and documents.

How dates are calculated

Each task gets a length

max(effort, timespan) + buffer + ceil(effort × validation complexity) days. Milestones and deliverables have no length.

Each task starts after its dependencies

A task starts when the last task it depends on has finished (finish-to-start), plus an offset in days if you drag its bar later. Tasks inside a phase can't start before the phase does.

The editor repeats until nothing moves

Phases stretch to cover their tasks, milestones sit where their tasks end, and the whole pass runs again until no date changes, or up to 1,000 times.

Plans import from JSON and from Mermaid Gantt files (.mmd or .txt), and export to JSON, Mermaid and SVG.

Tips for better project plans

Break tasks down small

Huge, multi-week tasks are hard to estimate and hide problems. Aim for pieces of no more than 3–5 days of effort: they are easier to estimate, track and hand over if someone gets blocked.

Use buffers where the risk is

Don't add the same buffer to every task. The buffer settings let you set a default per task type, so design or testing, which tend to involve review cycles, can carry more than routine documentation.

Model only real dependencies

Link two tasks only when one truly can't start before the other ends. Over-linking turns the plan into a single line and hides the work that could happen in parallel.

Define deliverables first

Before adding tasks, write down what the project has to produce. Working back from outputs to tasks keeps the plan focused on what gets delivered, not on a list of activities.

Make review time explicit

Validation complexity adds review time on top of effort: 0.5 adds half the effort, 1.0 the same again, and 2.0 twice the effort. The editor has no field for it yet: set validationComplexity in an exported JSON file and import it back. Use it for work that goes back and forth with a client or a reviewer, instead of padding the effort.

Export often

Your plans live in this browser only. Export a JSON copy before and after each planning session: it is your backup, and a record of how the plan changed.

What we learned

  • A schedule doesn't need a graph library. Instead of sorting tasks by their dependencies, the editor pushes each task forward until its dependencies are met and repeats the pass until nothing changes. It is simple to follow, handles phases nested in phases, and the 1,000-pass limit keeps a circular dependency from freezing the page.
  • Mermaid is a good way out, and a lossy way in. Exporting to Mermaid puts a plan anywhere that renders Markdown. Importing it back loses everything Mermaid has no words for, such as buffers and review time, so JSON remains the format to keep.
  • Buffer and review time are different things. A buffer covers what you can't foresee; review time is what you know will happen. Keeping them apart in the calculation shows, in the task's tooltip, why it is long.

Limitations

What Andamio doesn't do, so you can decide before you start.

  • No real-time collaboration. There is no server, so there is no shared copy: to share a plan, you export a JSON file and the other person imports it.
  • No critical path and no slack. Tasks are pushed forward until their dependencies are met, and that is all the scheduling there is.
  • Only finish-to-start dependencies, with an optional offset in days that you set by dragging. No start-to-start, finish-to-finish or lag as a percentage, and a dependency can't be removed from the editor once drawn.
  • Validation complexity is part of the date calculation, but the editor has no field for it yet: it comes from an imported JSON file.
  • No resource planning: you can't assign people to tasks or see who is overloaded.
  • Plans live in your browser's localStorage, usually limited to about 5 MB per site, and clearing the site's data deletes them.
  • The Mermaid export, and the SVG made from it, is simpler than the plan in the editor: drag offsets aren't exported, and tasks nested inside a deliverable can be left out. Keep the JSON as the full copy.
  • Importing from Mermaid keeps phases, tasks, durations, dependencies and statuses, but Mermaid has no buffers or validation complexity, so those start at zero.

Frequently Asked Questions

Is Andamio free?

Yes. There are no paid tiers, no ads and no account. Every feature is available to everyone.

Where are my projects stored?

In your browser's localStorage, on your device. The editor does not send your projects anywhere. The flip side is that clearing this site's data in your browser deletes them, so export a JSON copy from time to time. Browsers usually allow around 5 MB per site, which is plenty for plans but not unlimited.

How is a task's length calculated?

A task lasts max(effort, timespan) + buffer + ceil(effort × validation complexity) days. Effort is the work, timespan the calendar days you give it, and buffer a safety margin you add by hand. Milestones and deliverables have no length.

What is "validation complexity"?

A multiplier from 0 to 2 for the review rounds a task needs. It adds effort × validation complexity days, rounded up. At 0 it adds nothing; at 0.5, half the effort; at 2.0, twice the effort. For example, a task with 4 days of effort, 1 day of buffer and a validation complexity of 0.5 takes 4 + 1 + 2 = 7 days. The editor doesn't have a field for it yet: you set validationComplexity in an exported JSON file and import it back.

Does it calculate the critical path?

No. Each task starts when all the tasks it depends on have finished (finish-to-start), plus an optional offset in days, which you set by dragging the task's bar. The editor moves tasks forward until every dependency is satisfied, but it does not compute slack or highlight a critical path.

Can I import an existing Mermaid Gantt chart?

Yes, from a .mmd or .txt file. The importer reads the title, turns each section into a phase, and keeps each task's duration, its after dependencies and the active, done, crit and milestone tags. Mermaid has no buffers or validation complexity, so those start at zero. You can also import a .json file exported from the editor.

How do I put my chart on GitHub or Notion?

Export it as a .mmd file and paste the code into a ```mermaid block in a GitHub README, or into a Notion code block with Mermaid as the language. Both render the chart. For slides, export an .svg instead.

Can I work on a plan with my team in real time?

No. There is no server, so there is no shared copy to edit together. To share a plan, export it as JSON and send the file; the other person imports it into their own browser.
